Ich eröffne hier mal noch einen weiteren Thread zu Macmin, da in den
bestehenden Threads wie fast immer nur schrott drinn steht.

Heimatland:AustralienHeimatbörse:Sydney/MelbourneWährung:AUDBörsenkürzel:MMNWKN:897 010ISIN:AU000000MMN6



Börsennotierungen

AustralienDeutschlandUSAKurseMMN Kurse897 010 KurseMCAJF.PK
(Verkleinert auf 93%) vergrößern

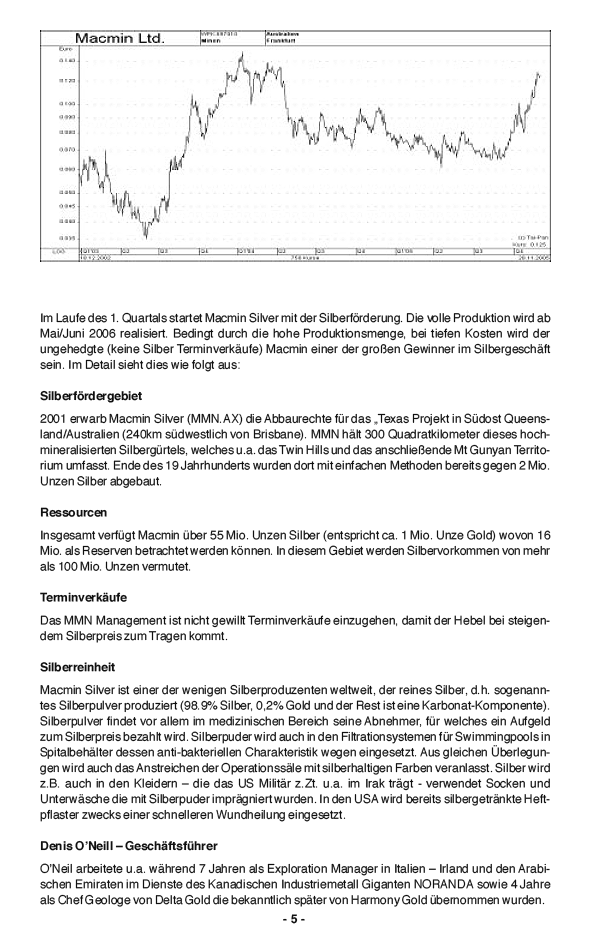

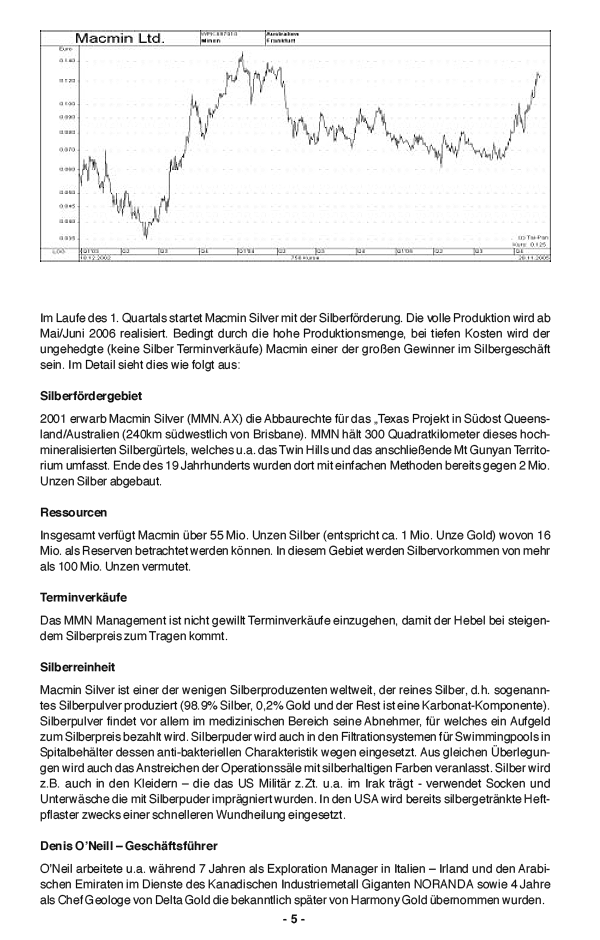

Macmin Silver 23880

Werbung

Entdecke die beliebtesten ETFs von SPDR

SPDR MSCI World Technology UCITS ETF
Perf. 12M: +43,05%
SPDR S&P U.S. Technology Select Sector UCITS ETF
Perf. 12M: +40,33%
SPDR MSCI World Communication Services UCITS ETF
Perf. 12M: +36,94%
SPDR S&P U.S. Communication Serv. Select Sector UCITS ETF Ac
Perf. 12M: +36,17%
SPDR MSCI Europe Technology UCITS ETF
Perf. 12M: +28,49%

Macmin Silver Pate100
Pate100:

... o. T.


27.12.05 17:06
#2
(Verkleinert auf 93%) vergrößern

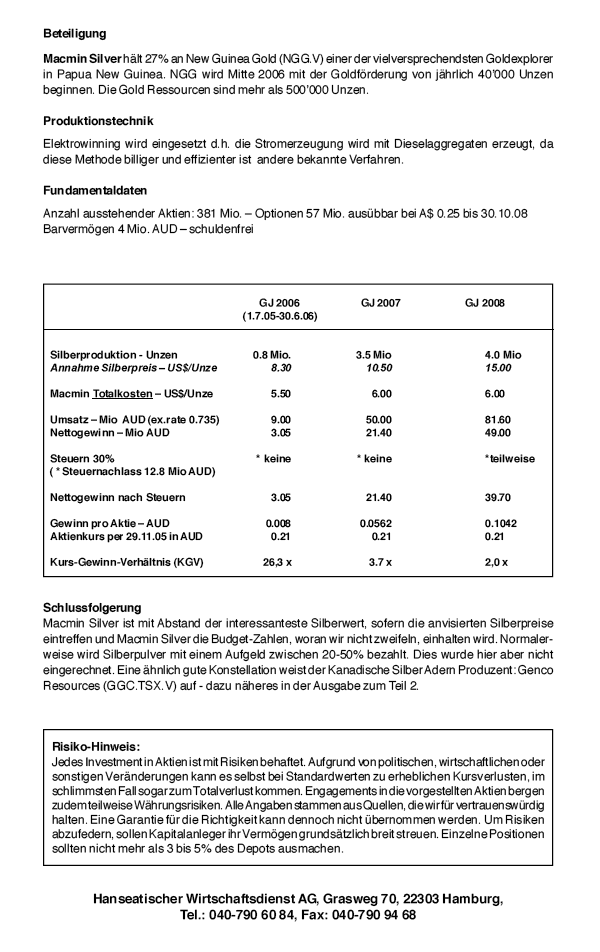

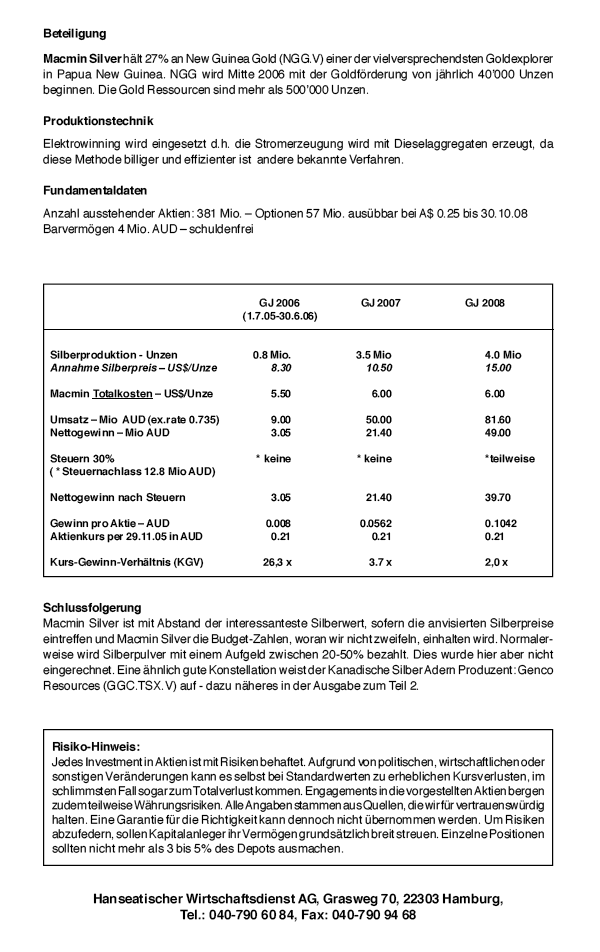

Macmin Silver 23881
Macmin Silver Pate100
Pate100:

Technical Report


27.12.05 17:10
#3

TECHNICAL REPORT - QUARTER ENDED 30TH SEPTEMBER 2005

[Also available as a PDF File (328K)]

Macmin Silver 2300332

1. SUMMARY & COMMENTS

Macmin Silver Ltd (Macmin) is a silver focused company whose primary project is the Texas Silver Project, S.E. Queensland, Australia. Macmin has exposure to gold by way of a 27% equity in New Guinea Gold Corporation (NGG) and a 1% NSR royalty on production by NGG. In addition, Macmin maintains equity investments in junior Australian explorers, Malachite Resources NL and TasGold Ltd.

  • Construction activity continued at Twin Hills during the quarter with the laying and welding of the High Density Polyethylene (HPDE) liner over the heap leach pad and leach ponds.
  • Final designs of the dam wall and spillway for the Storm Containment Dam were completed. Preliminary vegetation clearing was undertaken and geotechnical investigations of bedrock below the proposed dam wall were carried out.
  • The exercise of listed MMNOA options raised $1,006,592 (before costs). The balance of those options expired on 20 September 2005.
  • A placement to investors of shares and options on October 11 raised $1,689,200 (before costs).
  • NGG announced significant intervals of high grade molybdenum assays from trenching at the Simuku Project, PNG.

Macmin Silver 2300332


2. TEXAS SILVER MINES PTY LTD

The Texas Project (EPMs 8854, 11455, and 12858; ML 5932 and ML 50161) is located 100km west of Stanthorpe. Texas Silver Mines Pty Ltd is a wholly owned subsidiary of Macmin Silver Ltd.

2.1 Twin Hills (ML 50161) - Development Activities

  • Construction work continued at the Twin Hills minesite throughout the quarter. Final shaping of the leach pad and ponds area was undertaken prior to the laying and welding of the High Density Polyethylene (HPDE) liner.
  • Final designs of the dam wall and spillway for the storm containment dam were finalized by the engineering consultants. Vegetation clearing in the base of the dam has been carried out and geotechnical investigations of the bedrock below the proposed dam wall were undertaken.
  • A further forty (40) tonnes of crushed ore is being prepared for leaching test work.
  • A programme of ‘grade control' drilling was carried out over the central part of the Twin Hills orebody. This drilling was aimed at delineating the initial 200,000 tonnes of ore to be extracted. This programme was very successful in providing in data for mine planning purposes and will therefore be continued over the bulk of the orebody prior to surface disturbance by mining.

2.2 Exploration Drilling

A programme of percussion drilling comprising seventeen (17) drill holes for a total of 745 metres was undertaken at the Toolbox Prospect, approximately 3.5km north of Twin Hills. This programme tested a low level base metal anomaly previously defined by soil geochemistry. Assay results have not been received from this programme.


The following releases were made to ASX in the third quarter of 2005:

17th August 2005

"TWIN HILLS SILVER MINE CONSTRUCTION UPDATE

The progress of construction undertaken around the Twin Hills mine site is highlighted in a series of photos which form part of this update.

  • Unseasonal wet conditions in late June and throughout July have delayed the final shaping of the leach ponds and pad area until this week. Ground conditions for the laying and welding of the High Density Polyethylene (HDPE) liner have to be very dry to ensure quality welding and the integrity of the seams. The HPDE liner has been delivered to site and will be laid once a contractor ‘crew' is available.
  • The requirement for crushed and screened ‘products' to be used during the construction activity has resulted in the commissioning of the Extec crushing and screening plant units. Waste rock and alluvium source materials, located within the Twin Hills Mining Lease, have been utilised for this purpose. As an example, one of these products is being used as the underlay protection layer for the HDPE liner on the leach pads and in the process ponds.
  • Test work on the thirty (30) tonne silver ore sample extracted from a small surface slot near the top of the Twin Hills ore deposit is ongoing. Whilst a quantity of silver powder has been obtained, tests are in progress to optimise the leaching, stripping and purity of the silver powder.
  • A programme of ‘grade control' drilling is currently being undertaken over the central part of the Twin Hills ore body. The aim of this drilling is to delineate the initial 200,000 tonnes of ore to be extracted from the deposit. Once this ore is mined, crushed and agglomerated, it will be stacked in 50,000 tonne cells on the heap leach pad where it will undergo leaching. These ‘pregnant' solutions from the heaps will be pumped through the electrowinning circuit as part of the commissioning phase to optimise the production of the silver powder product.
  • Delays encountered during the construction phase, including wet weather and longer than anticipated lead times in sourcing all the components for the crushing (ex UK) and stacking circuits have meant that the construction phase has been extended. We had initially hoped to finish construction by October, but now believe that construction will be completed prior to the end of 2005.
The rise in the silver price over the last six months has not advanced as strongly as we might have anticipated, but is rising nonetheless. It has always been the intention of the Company to commence silver production once a strong up-trending silver price is in place; as the management is committed to maximising shareholder value from the development of the present reserves. The delays incurred to-date are not expected to adversely impact on the project.

Our present schedule is to complete construction towards the end of 2005, commission the plant in early 2006 with full production (subject to silver price) soon thereafter."

Macmin Silver 2300332

14th September 2005

"GRADE CONTROL DRILLING AT TWIN HILLS CONFIRMS CONTINUITY OF SILVER ORE

A campaign of ‘grade control' drilling will be completed over the central part of the Twin Hills silver ore deposit this week. This drilling infilled the previous ‘reserve status' drilling on a 6m by 6m block basis over the top 10-15m of the deposit and is aimed at delineating the initial 200,000 tonnes of ore to be extracted.

Assay results from ALS Chemex Laboratories in Brisbane have been received for approximately 70% of this programme and are tabulated in the attached table. Although these results do not add to the ‘reserves' base at Twin Hills, the consistent high tenor of values over significant widths provide added confidence about the continuity of silver ore in the upper part of the orebody.

Once the construction phase at Twin Hills is completed, currently scheduled to be the end of 2005, the ore defined in this grade control programme will be blasted and mined. Then it will be crushed and agglomerated prior to being stacked in 50,000 tonne cells on the heap leach pad, where it will undergo leaching. Solutions from the heaps will be pumped through the electrowinning circuit as part of the commissioning phase to optimise the production of the silver powder product."


17th October 2005

"FINAL RESULTS FROM INITIAL CAMPAIGN OF ‘GRADE CONTROL' DRILLING
AT TWIN HILLS

On September 14, a release to ASX provided assay results for 70% of the recently completed ‘grade control' drilling at the Twin Hills Silver Mine.

The remaining 30% of results has now been received and mineralised intervals exceeding 60g/t silver are tabulated.

The highest individual assay in the programme was encountered in Hole GTH053 where 2m at 1,390g/t silver was intersected between 18 and 20m downhole, whilst the best mineralised intercept occurred in GTH064, which averaged 20m at 366g/t silver over the entire hole.

This initial campaign of ‘grade control' drilling was planned to in-fill the previous ‘reserve status' drilling on a 6m x 6m block basis over the top 10-15m of the deposit in the central area, where the initial 200,000 tonnes of ore is to be extracted.

The success of truck mounted drilling programme, in providing detailed geological data for mine planning purposes, has meant that this programme will be continued over the bulk of the orebody in the near future. Accessing the area to be drilled, prior to surface disturbance by mining, is proving to be a time/cost effective way of obtaining a large amount of assay data to optimise mine planning prior to start-up of the operation."

3. CORPORATE

The following releases were made to ASX in the third quarter of 2005:

12th August 2005

"EXERCISE OF OPTIONS

The Directors advise that a total of 20,000 fully paid ordinary shares were issued today at an issue price of 12 cents each pursuant to the exercise of 20,000 MMNOA options expiring 20 September 2005."


9th September 2005

"EXERCISE OF OPTIONS

The Directors advise that a total of 186,200 fully paid ordinary shares were issued today at an issue price of 12 cents each pursuant to the exercise of 186,200 MMNOA options expiring 20 September 2005."


22nd September 2005

"ALLOTMENT OF SHARES PURSUANT TO EXERCISE OF MMNOA OPTIONS

The Company will, subject to clearing of funds, issue 8,182,065 shares pursuant to the exercise of MMNOA options which expired on 20 September 2005. The issue is expected to occur next Wednesday 28 September 2005.

The exercise of options at 12 cents has raised $981,847.80 before costs."


11th October 2005

"ISSUE OF SHARES AND OPTIONS PRIVATE PLACEMENTS FINALISED

The Company has completed the issue of 14,076,667 shares and 4,692,222 free attaching MMNO options to 17 placees that was announced on 4 October 2005."

4. INVESTMENTS

Macmin maintains equity investments in the following public companies with exposure to the precious and base metals sectors. Information and releases about these companies' activities can be found on each company's website.

Company
Shares
Options
Market Value
30 September 2005
New Guinea Gold Corporation (TSX)
www.newguineagold.ca
17,596,520
-
$5,320,000
Malachite Resources NL
www.malachite.com.au
1,500,000
750,000
$165,000
TasGold Ltd
www.tasgold.com.au
1,698,157
1,437,500
$270,220

5. NEW GUINEA GOLD CORPORATION

Two of the more significant releases by New Guinea Gold during the quarter are included as follows:


15th September 2005

"NEW GUINEA GOLD ANNOUNCES RESOURCES ESTIMATES AT SINIVIT GOLD PROJECT

Vancouver, September 15, 2005. New Guinea Gold (NGG:TSX-V) is pleased to announce mineral resource estimates for the Sinivit gold deposit in Papua New Guinea. These resources were defined, in part, by 122 diamond drill holes totalling 18,067 metres, and 75 reverse circulation percussion (RC) holes totaling 2,987 metres. The drilling emphasized a strike length of approximately 1,000 metres covering the Southern Oxide Zone (9810 N to 10000 N), the Central Oxide Zone (10000 N to 10180 N), the Northern Sulphide Zone (10180 N to 10400 N) and the Northern Oxide Zone (10400 N to 10550 N).


Mineral Resource Estimate:

The following tables shows the Indicated Mineral Resource and Inferred Mineral Resource estimates for the Sinivit deposit.

Category
Tonnes
Gold (g/t)
Contained gold
Indicated - Oxide
413,000
4.4
58,000
Indicated - Sulphide
300,000
7.6
74,000
Indicated - TOTAL
713,000
5.7
132,000
Inferred - TOTAL
340,000
3.2
35,000

Mineral resources that are not reserves do not have demonstrated economic viability. Measured and indicated mineral resources are that part of a mineral resource for which quantity and grade can be estimated with a level of confidence sufficient to allow the application of technical and economic parameters to support mine planning and evaluation of the economic viability of the deposit. An inferred mineral resource is that part of a mineral resource for which quantity and grade can be estimated on the basis of geological evidence and limited sampling and reasonably assumed, but not verified.

The resource estimate has been confirmed by Project Geoscience Pty Ltd, which is independent of New Guinea Gold and is classified to conform to the CIM definitions referred to in National Instrument 43-101. Ralph Stagg, B.Sc, M.Sc, F.AusIMM, CP, DIC, MIMMM, C.Eng, who has 35 years experience in the exploration, mining, engineering and investment fields served as the Independent Qualified Person responsible for this estimate and the preparation of the independent report in accordance with NI 43-101.

Project Geoscience Pty Ltd has reviewed this disclosure and consents to its release. Ralph Stagg, the independent Qualified Person has reviewed the data and the work by other independent and non-independent Qualified Persons, agrees with the mineral resource estimates and concurs with the estimated reported. The Independent Report will be filed on Sedar within 30 days.

Mr. Stagg visited the property on August 23, 2005 and inspected the mineralized outcrops, drill sites, drill core and other on-going activities such as preparation of haul roads, vat leach sites, etc. Mr. Stagg reviewed all aspects of the resource estimates including, but not limited to the following;

  • Geology, deposit type and mineralisation
  • Weathering
  • Drilling, including compilation of all drill holes and trenches by cross-section, used in the estimate
  • Sampling methods and details
  • Factors effecting reliability of samples
  • Sample preparation, analyses and security
  • Assay procedures, quality and checking
  • Quality control and verification procedures
  • Mineral processing and metallurgical testing
  • Methodologies of resource estimation
  • Categorization of resources
  • Permitting
  • Capital and operating costs
  • Economic analysis

These items are all dealt with in detail in the "Technical Report on the Sinivit Property, Papua New Guinea" by R.N. Stagg B Sc, MSc, DIC, FAusIMM, CP, MIMMM, CEng, which will be lodged on Sedar within 30 days.

Background

The Sinivit Gold Project is located 50km south-southwest of Rabaul in the East New Britain Province, Papua New Guinea. It can be accessed by road from the town of Kokopo and port of Rabaul. A jet airport at Kokopo has several daily flights to Port Moresby and Lae. The Company announced on June 16, 2005 that all approvals had been received from the Papua New Guinea Government in respect to commencing development of the Sinivit Gold project.

Historic resources were included in an independent feasibility study on the Sinivit gold deposit by Ausenco Ltd, a Brisbane, Australia engineering company, dated 11 December 1995. These resources were estimated by independent and non-independent Qualified Persons under the supervision of Robert D. McNeil, B.Sc. Honours, MSc. Fellow of the Australian Institute of Mining and Metallurgy and Dr David Lindley, B.Sc. Honours, Ph.D. Member of the Australian Institute of Geoscientists, both of whom are Qualified Persons as defined by N.I. 43-101 and both persons consent to this public disclosure. Mr McNeil is now chairman/CEO and Dr Lindley is Exploration Vice President of New Guinea Gold Corporation. These resources have an effective date of September 12th 2005, are now considered current, and comply with the requirements of N.I. 43-101.

New Guinea Gold has an active exploration/development progam with the objective of defining additional gold mineralisation. The known mineralisation is open at depth and there are numerous other, as yet unexplored targets within the Sinivit properties. The potential to increase mineralisation at the project has been described in the independent Technical Reports by Peter Christopher, PHD, P. Eng, which is available at www.newguineagold.ca.

The Company commenced development at Sinivit in July 2005 based on the historical estimates of reserves and resources in the 1995 independent Feasibility Study prepared by Ausenco Ltd of Brisbane, and an update of this historical feasibility study. Investors are cautioned that the development is proceeding in the absence of a feasibility study prepared by an independent Qualified Person that determines and supports the economic viability of the project, and, as such, the financial risk of the project may be higher.

Key Assumptions, Parameters and Methods Used to Prepare the Mineral Resource Estimate

Deposit Description

Both oxide and sulphide vein resources are present in the project area. Gold and silver bearing oxidised vein material forms, on average, a 30 m thick surficial zone overlying gold-copper-silver-telluride bearing veins. Supergene oxidation has typically resulted in the total removal of copper and tellurides and the partial leaching of gold and silver from primary mineralisation. Oxide resources have been identified in the Sinivit vein (Southern, Central, and Northern Oxide Zones), and the Kavursuki vein. Work to date has delineated a sulphide resource in the Sinivit vein (Northern Sulphide Zone).

Downhole Survey

All drill holes were surveyed for dip and azimuth at the collar, and six holes have been surveyed downhole. The dip and strike of these downhole surveyed holes differs very little from that measured at the collar. For example, hole WDD035 is 220 metres long. Its dip dropped from 60° to 64°, and its azimuth from 105° to 108° over the full hole length.

Drilling

Since 1984, the Sinivit Prospect has been under intermittent, though often intensive investigation. As well as trenching, detailed mapping and sampling, a total of 122 diamond drill holes have been put down for 17,775 metres, and 62 reverse circulation percussion (RC) holes for 2,600 metres.

The drilling has been concentrated within a strike length of approximately 1,000 metres covering the Southern Oxide Zone (9810 N to 10000 N), the Central Oxide Zone (10000 N to 10180 N), the Northern Sulphide Zone (10180 N to 10400 N) and the Northern Oxide Zone (10400 N to 10550 N).

Trench Sampling

A series of trench samples were taken across the Central reef in the Southern and Northern Oxide Zones. Bulldozed cuts across the zones of massive resistant silicification were facilitated in areas where intense post-mineralisation cross-fracturing has imparted brittle fracturing. Trenches were along bulldozed cuts and allowed recovery of samples from surface to around 2 metres depth into the reef. Although designed to sample across the reef the trenches did include samples both along and across strike.

In many of the trenches, individual and average grades are significantly higher than the grades obtained from drill holes directly beneath them. Since the trenches were sampled in, along and across strike, and care was taken to collect the full sample interval, the trenches returned reliable "bulk" grades. One possible reason for the discrepancy between the drill and trench samples could be that the drill holes may have followed down along the weakened zones of cross fracturing rather than drilling through the un-fractured mineralisation. It is likely that the fractures would exhibit more intense leaching than the surrounding un-fractured ground.

Assaying and Sample Preparation

Conventional RC drilling sampling was carried out, with samples collected in a bag which allowed dewatering by overflow, and diffusion through the bag surface.

On site preparation included drying, weighing and riffle splitting into one quarter/three quarter splits. Consecutive one quarter splits were combined and dispatched until mid 1986 to Pilbara Laboratories in Lae, then after this date to PNG Analytical, also in Lae.

At the laboratory, the sample was first crushed to -40 mesh by a roll mill, then to -60 mesh by a Keegor mill.

Finally, the sample was pulverised to -150 mesh, and gold values derived by fire assay of a 50 gram charge, with atomic absorption spectrophotometer (AAS) finish.

If assays of +0.5g/t Au were obtained, a second quarter split on an individual metre basis was submitted for analysis.

Diamond drill half core samples submitted to the laboratory were prepared in the same way, except that a preliminary jaw crushing stage was introduced.

All gold determinations to March 1987 were completed on 50 gram charges. During March 1987, trial analyses of both 50 gram charge and 25 gram charge determinations were completed on 50 samples, ranging in gold content from below the assay detection limit to 12g/t Au.

The results showed close correlation, after which the laboratory routinely completed gold analyses on 25 gram charges on all Sinivit samples.

Check Assays

Interlaboratory checks were completed during September 1986 and July 1987. The July 1987 check included in excess of 300 samples, with determinations done on a 50 gram charge basis by the check laboratory versus 25 gram charges by the initial laboratory.

Standards have been used since October 1985 on a one in ten basis. Up to the end of 1986, three standards: < 0.01g/t Au, 0.9g/t Au and 4.9g/t Au were rotated. Commencing 1987, six standards were used, at least two assaying 2.5g/t Au, two assaying 8g/t Au and one assaying < 0.1g/t Au.

Basic Statistics for Oxide Indicated Resource

The drill hole gold assays were composited on 2 metre intervals to correspond to the probable mining bench height and preliminary statistical analyses were conducted. In order to eliminate potential along strike variations the data was grouped into two sets. The Southern and Central Oxide Zones formed one set while the Northern Oxide Zone formed the other. The geological structure is too complex to allow detailed definition of the economic grade zones at this stage so the "ore" zones were selected by a visual assessment of the grade separating mineralised zones from the background mineralisation. This was 0.30 g/t Au for the Southern and Central Oxide Zones and 0.40 g/t Au for the Northern Oxide Zone. Statistics for the two areas are summarised in Table 3.4.

Table 3.4 Oxide Zone Statistics


Southern and Central
Oxide Zones
Northern Oxide Zone
No. of 2 m Composites
527
31
Minimum Assay
0.30
0.40
Maximum Assay
50.40
37.96
Mean
2.47
3.35
Variance
20.26
56.25
Standard Deviation
4.50
7.50
Coefficient of Variance
1.82
2.24

The spread of values for the Southern and Central Oxide Zones are typical of many gold deposits. A coefficient of variance below 2.00 for gold is not excessive. Results from the Northern Oxide Zone are much more scattered. This is probably due to the small number of composites which is too low to allow useful analysis of grade distribution.

Grade frequency histograms and cumulative frequency plots were prepared for both populations. Each showed a major skew to the lower grades, even using log transformed data. This is despite the fact that lower grade limits were applied in both cases. Much more detailed examination of the drilling data is required to determine the reasons for this skewed distribution. It may be, for example, that the holes have followed down leached fractured zones. However the data in its current form is not suitable for detailed geostatistical analysis.

In Situ Bulk Density

Specific gravity measurements were made on approximately 130 core and rock chip samples during September and October 1995. These samples were selected from surface to 30 metres depth from each of the Southern, Central and Northern Oxide Zones. Nearly all of the samples were closely clustered around an average of 2.61 t/m³. This agrees well with the average specific gravity of quartz at 2.65 t/m³.

Specific gravity used for the Sulphide Indicated/Inferred Resources and the Oxide Resource at Kavursuki was 2.5.

Computer Database and Modelling System

Orebody modelling, resource estimation and mine design were carried out using SURPAC 2000 software. A SURPAC database was compiled incorporating:

  • Drill hole collar coordinates and levels in the local grid system.
  • Drill hole types (reverse circulation or diamond core).
  • Drill hole dips and azimuths.
  • Gold primary and repeat assays and an average of the two used in the resource modelling.
  • Copper assays.
  • Silver assays.

A topographic model was prepared by digitising contours from the most recent aerial photography. It was later noted that this photography was impeded by the dense tree canopy and is not accurate in places. The surveyed drill hole collars were included in the model to improve its accuracy.

Geological In Situ Resource Estimation.

Geological interpretation and delineation of the quartz veins was undertaken by Dr David Lindley.

Definition of the grade zones within the geological boundaries and subsequent sectional modelling of the resource and reserve in SURPAC was undertaken by John Wyche of Australian Mine Design and Development Pty Ltd.

Resource Estimation Procedure

The following steps were carried out in the resource estimation:

  • East-west section lines were defined along the baseline to group the drill hole and trench data as closely as possible within the known fault blocks.
  • Drill hole cross sections were extracted on the defined lines showing hole name, hole trace, average gold grade and copper grade in each uncomposited sample interval.
  • Topography cross sections were taken through the topography model on each of the section lines.
  • Cross section plots showing the drill hole data and topography were produced at 1:250 scale on each section line.
  • The reef structures were drawn onto the sections using data from the original drill logs and outcrop mapping.
  • A cut off grade of 0.5g/t gold was chosen as it appears to provide adequate definition of the mineralised zones while still being at the lower end of potentially economic grade.
  • Resource polygons were marked out on each section by following the 0.5 g/t gold envelopes within the interpreted quartz reef structures. The shape of the polygons takes into account:
    • The occurrence of cross faulting as logged in trenches, core, or as interpreted from drilling difficulties.
    • The occurrence of cross cutting dykes.
    • Topography.
    • Polygonal interpretations on adjacent sections.
  • Where polygons were defined by more than one drill hole they were split half way between the drill holes to limit the grade interpolation distance.
  • Polygons were not generally extended more than 10 metres up or down dip from the last hole on a section. This distance is probably less than the range of continuity in the mineralisation but the structural complexity of the deposit limits confidence in the extrapolation of the mineralised pods.
  • Each section was assigned an along strike width of influence extending half way to the sections either side. The two end sections (9810 N and 10550 N) were extrapolated 20 metres beyond the section plane.
  • Normally at this stage the polygon areas on each section would be multiplied by the along strike width of influence to calculate the ore volume. However the steep topography at Sinivit could give rise to major volume errors with ore being extrapolated into air. The following procedure was used to clip the orebody model against topography:

    • Each section polygon was sliced at 2 metre vertical intervals. The slices were extended half way to each adjacent section to form rectangles in plan view with along strike lengths equal to the section widths of influence.
    • The rectangles carry the grades of the polygon from which they were extended. The result is a sort of block model made up of rectangles defining the ore zones on each 2 metre bench.
    • The topography model was contoured at the same 2 metre vertical interval and the contours were used to clip off the parts of the interpolated/extrapolated ore rectangles which had been extended beyond natural surface.
    • Each bench was given a vertical width of influence of 2 metres. It was thus possible to multiply the areas of the slipped rectangles by 2 metres to calculate an ore volume. This was multiplied by the oxide ore bulk density of 2.61 t/m³ to calculate the ore tonnage.
    • The gold and copper grades for each clipped rectangle were combined as tonnage weighted averages for each bench and each zone.
Resource Categories

Resource categories are designed to give interested parties a measure of the confidence with which the resource tonnes and grade have been estimated. Much of the Sinivit resource has been drilled at less than 25 metre centres. Such a close spacing combined with the procedures already noted, is used, this would normally assist in the classification of a measured resource but three main factors prevent this.

Steep topography makes drilling of regular section lines impossible. This makes interpretation of mineralisation and structures more uncertain.
  • Frequent, irregular cross faulting decreases confidence in interpolation and extrapolation of structures.
  • Discrepancies in grade between trench samples and adjacent drill holes remain unexplained.

However, on the one section of exposed reef which has been thoroughly mapped and sampled the structure and gold distribution is well understood and this model is consistent with the ore polygons delineated on each section. An adequate model exists for the structure of the host system and the distribution of gold within it but the small scale of the structures and the irregularity of the drilling make it impossible to fully define each intersected zone of mineralisation. For this reason the entire resource model is classed as indicated.

Diamond Twin Holes

Diamond twins were completed adjacent two reverse circulation holes during the 1986 program; viz: WDP010/WDP022 and WDP004/WDP021. These holes were collared within 2 to 4 m of each other and 100% core recovery was obtained from cored holes. Comparison of the Au results from these holes by J. Whyce and I.D. Lindley, indicate a "perfect" match in downhole reverse circulation geochemistry with respect to that of the corresponding drill hole.

Check Sampling by New Guinea Gold Corporation

A program of surface and drill core check sampling was completed in January 2004 on the Northern, Central and Southern Oxide and North Sulphide Zones of the Sinivit deposit. These results confirm the reliability of the original drill assays. In addition a 13.20m core assay (7.15 to 20.35m down-hole) was split into 10 splits to study the "nugget effect", if any, of the Sinivit oxide ore. The original assay was 12.4 g/t gold and the splits assayed as follows: 14.85, 18.4, 15.45, 15.4, 18.25, 7.47, 18.45, 6.8, 6.85, 7.53 (average -13.0 g/t gold). These results show there can be significant variation between splits, but the average grade is similar to the original grade.

Four large bulk samples (60-100kgs) were collected from surface trenches to check the tenor of gold at the surface. Each sample was crushed and split into 10 separate samples to check for the "nugget effect" and assay repeatability. The results confirm extensive gold at the surface and show there is relatively minor variation between splits and only minor "nugget effect".

Open Pit Design

The resource model was modified to account for mining dilution and a set of three pits was designed to maximise gold recovery in low copper oxide mineralisation. The goals of these designs were to extract as much gold mineralisation above the 0.5 g/t Au cut off as possible while minimising the volume of high copper mineralisation exposed and keeping the waste : ore ratio as low as possible.

Geotechnical

The geotechnical design parameters were selected on the following premises:

  • The mineralisation zones occur in two, and sometimes three, quartz reef structures which run the full strike length of the deposit. These reefs provide reinforcement to the rock mass.
  • Although there is an extensive blanket of very weak oxidised clay material the majority of the rock mass outside the reefs comprises tuffs of moderate to competent strength.
  • Most of the structures are near vertical.
  • Bulldozer cuttings with near vertical walls of eight to ten metres height have stood for nearly ten years.
  • Natural slopes of greater than 1 in 1 are not uncommon.
  • The occurrence of high copper grades at shallow depths limits the pits to 30 metres depth.
  • The pits will have short lives, generally less than one year each.

The overall pit wall slope selected is 62° which is formed by a face slope of 70° with a 4 metre berm every 16 metre vertically. This slope is flattened in places by the inclusion of ramps and widened ore benches.

Metallurgical Testwork

There are two distinct mineralisation types - oxide and sulphide.

Metallurgical testwork on the Sinivit oxide deposits has been undertaken by a number of groups including City Resources, Warman Laboratories, Ed Newman & Associates and the Julius Kruttschmitt Research Centre. Ed Newman & Associates prepared a review of testwork in July 1994. The gold mineralogy of the oxidised mineralisation is not clear, but cyanide leach liquor assays contain low levels of tellurium, arsenic and copper, suggesting extensive oxidation and remobilisation of gold into leachable forms.

Bond Work Index determinations were completed on oxide ore samples indicating an index of 11.2 KWh/tonne which is low for quartz type materials. The ore is indicated to be composed of many fracture planes.

Column leach testwork carried out in 2003 - 2004 by Macmin and AMMTEC have indicated that material crushed to minus 12.5 mm is leachable in cyanide. Recoveries up to 92 % were obtained with cyanide consumptions of 0.65 kg/t. Ammtec's figure of 88% has been adopted. This has indicated that vat or heap leaching is a viable option for recovery of gold from the oxide material.

Data suggests that gold in sulphide mineralisation is mainly present as gold telluride which is refractory to cyanide leaching. There is sufficient sulphide mineralisation testwork available, however, to show that a flowsheet involving a simple flotation scheme, in a low cost flotation cell such as the Jameson cell, followed by shipment to Mt Isa (or other smelter) for treatment in the copper Isasmelt vessel would be feasible. The presence of an existing infrastructure to mine the oxidized ore, should make this option feasible."

3rd October 2005

"MOLYBDENUM TRENCH INTERSECTION AT SIMUKU
INCREASED TO 72m GRADING 1664ppm MOLYBDENUM

Vancouver 3rd October 2005. The molybdenum in bulldozer trench at the Simuku porphyry copper/molybdenum/gold prospect has increased from the previously reported 21m @ 1513ppm molybdenum to 72m @ 1664ppm molybdenum. This section is within a longer, lower grade section of 132m @ 989ppm molybdenum. These are very significant results - for example at the current molybdenum price of approximately US$35/lb, 1664ppm molybdenum has a value of US$115/tonne of rock (at present prices equivalent to 7.7g/t gold, not including copper and/or gold credits). Shareholders and investors are cautioned that molybdenum is at near record high prices, these prices may not be sustained in the future and that the comparison with gold is for information only as the treatment and recovery of molybdenum from molybdenum mineralisation is often more difficult and more costly than the recovery and treatment of gold mineralisation.
The Simuku prospect in West New Britain is owned 90% by New Guinea Gold Corporation (NGG-TSX.V) and 10% W.S. Yeaman. It is a large porphyry copper system with associated molybdenum and gold mineralisation. Detailed information on the property can be found in a Press Release dated 12 September 2005, and in the Independent report at www.newguineagold.ca .

The intersection described above is part of a 20km bulldozer trenching program, for which approximately one third of samples are still pending. The trenches were channel sampled at 3m intervals, approximately 3 to 4kg of sample collected and the samples were shipped to accredited laboratory, ALS-Chemex, in Townsville Australia for analysis. The results quoted above are molybdenum by the XRF method.

The trench intersection above is situated 250m NE of drill hole SMD002. It comprises a trench which partly encircles a ridge, i.e the trench passes along one side of the ridge around the top and along the far side. The trench suggests an area of mineralisation of at least 75m by 75m and is open on three sides. The nearest trench to the north is 200m distant. Management believe this is a significant area of molybdenum mineralisation.

Within the 72m @ 1664 molybdenum are several higher grade intervals:

  • 15m @ 3035ppm molybdenum
  • 6m @ 2582ppm molybdenum
  • 24m @ 1820ppm molybdenum
Approximately 4,000 samples have been collected in this program but all results will not be available, collated and assessed for at least 6 weeks."


D.M. O'Neill
MANAGING DIRECTOR




Macmin Silver Fundamental
Fundamental:

Hallo Pate


27.12.05 17:12
#4
Habe vom "Hanseatischen Wirtschaftsdienst" vor her noch nichts gehört.
Kannst` mir zu denen ein paar Infos geben ?

Danke & Gruß,
- Fundamental -
Macmin Silver Pate100
Pate100:

Share Purchase Plan


27.12.05 17:12
#5
SHARE PURCHASE PLAN

The Company is offering shareholders, who were registered at close of business on 12 December 2005, the opportunity to purchase up to 25,000 fully paid ordinary shares at an issue price of 20 cents each.

Details of the Plan, which will be mailed to all shareholders today, are attached.

An Appendix 3B in respect of the Plan is also attached.


Yours faithfully,
MACMIN SILVER LTD



Garry M. Edwards
Company Secretary

Encl.


--------------------------------------------------

13th December 2005


Dear Shareholder,

Re: MACMIN SILVER LTD (Macmin) SHARE PURCHASE PLAN (Plan)

THE COMPANY'S STRATEGY IN 2006 IS AS FOLLOWS:

Complete the construction of its first silver mine at Twin Hills, Texas Silver Project early in 2006.
Commence commissioning the silver extraction electrowinning plant in the first quarter of 2006, moving to sustained silver production in the second quarter of 2006. Annualised production could range between 2 and 3.5 million ozs silver depending on performance of the above plant and the silver price. If silver prices continue to climb the Company will plan to increase the above silver production if this is financially viable.
Carry out an aggressive drilling program in 2006, utilising two or more drill rigs, to allow conversion of existing resources to reserves to extend Twin Hills mine life; to complete an evaluation of the potential of the Mt Gunyan prospect as a future mine; to continue to build the Company's resource base at other prospects in the Texas district and on the Malachite joint venture.

Complete additional exploration and a pre-feasibility study on the viability of developing the zinc-silver resource at the Silver Spur mine and processing the high grade zinc slag (on surface) at Silver Spur. This slag is the residual from Silver Spur mining which ended about 1920. Contained metal value at today's prices is approx. $40 million, however the method and/or viability of recovery has yet to be determined.
Maintain exposure to gold through the Company's shareholding in Canadian listed New Guinea Gold Corporation and evaluate other opportunities .
We are aware that this financing will increase the issued capital of the Company but at present we are quite constrained in our ability to fully implement our strategy and to advance our projects. We believe that silver and gold prices will continue to rise in 2006 and if the Company is to significantly benefit from these increases we need to be able to fully implement our strategy now - not in late 2006 when cashflow from silver mining becomes fully available.

We suggest that the potential benefits to shareholders of implementing our development strategy now, at a time of increasing metal prices, far outweighs the increase in issued capital. The Silver spot price is currently USD$8.77 (AUD$11.59), which is a 17 year high for the metal.

The Company has no forward sales and no hedging in place and is thus able to benefit from all increases in the price of silver and gold. In addition, as the current resources are based on "cut-off" grades, as metal prices increase further mineralisation may be added to resources. Resources will be re-calculated in 2006.

The Company cautions however, although management believes the above strategy is achievable, there is no guarantee that resources will be converted to reserves, further resources will be defined, mines will be established at Mt Gunyan or Silver Spur, or that silver and gold prices will continue to increase in 2006.


THE PLAN

All shareholders, by participating in this discounted share plan, have an opportunity to participate in the potential benefits that may derive from a successful implementation of the Company's strategy.

Shareholders can acquire as little as $1,000, and as much as $5,000 worth of fully paid ordinary shares in Macmin at a subscription price of 20 cents per fully paid share. This price represents a 17% discount to market based on the weighted average price over the five trading days ended 9 December 2005.

Although the Plan has been left open for longer than usual, due to the festive season, the Directors may issue shares progressively rather than wait until the Plan closes and also reserve the right to close the Plan early.

The terms and conditions of the Plan and an Application Form are enclosed. Before deciding whether to accept this offer, please carefully read the Terms and Conditions and, in particular, please note part 12 - "Important Information on Price Risk to Consider."

Applications need to be received prior to the close of the offer at 4.00pm Sydney time on Tuesday 10 January 2006. If you wish to participate, please make cheques payable to "Macmin Silver Ltd" and forward your cheque together with the completed Application Form to Link Market Services in the enclosed reply paid envelope or BPAY as outlined on the form. If you have any questions in relation to the Plan, please contact me on (07) 5592 2274.

Please see the back of this letter, previous releases to the ASX, and the web site www.macmin.com.au for additional information.


Yours sincerely,
MACMIN SILVER LTD


G.M.Edwards
COMPANY SECRETARY
--------------------------------------------------


MACMIN SILVER LTD SHARE PURCHASE PLAN

Pursuant to the Macmin Silver Ltd Share Purchase Plan ("Plan"), Macmin Silver Ltd ABN 53 056 776 160 ("Macmin") offers eligible shareholders the ability to acquire between 5,000 and 25,000 fully paid ordinary shares in Macmin ("Shares") at 20 cents per fully paid ordinary share ("Offer").

Eligible shareholders may choose one of the following levels of acceptance.
25,000  shares for a total cost of $ 5,000
18,000  shares for a total cost of $ 3,600
12,000  shares for a total cost of $ 2,400
5,000  shares for a total cost of $ 1,000

Please carefully read the Terms and Conditions relating to the Offer, as you will be bound by them.

TERMS AND CONDITIONS

1. Opening and Closing Date of the Offer
The offer opens on 14 December 2005. The Offer closes at 4pm (Sydney time) on 10 January 2006. The Plan does not constitute an Offer in any place in which, or to any person to whom, it would be unlawful to make such an Offer.

2. Eligibility
You are eligible to apply for Shares if you were registered as a holder of fully paid ordinary shares in Macmin as at close of business 12 December 2005.

The Offer to each eligible shareholder is made on the same terms and conditions.

The Offer is non-renouncable (i.e. you may not transfer your right to buy the Shares to anyone else).

3. Issue Price
The issue price for each Share under the Offer is 20 cents.

4. Rights attaching to Shares
The Shares will be issued on the same terms as the other ordinary shares in Macmin quoted on the Australian Stock Exchange ("ASX"). Macmin will apply for the Shares allotted under the Plan to be quoted on ASX.

5. Investment in Offer
If you are an eligible shareholder, you can purchase :

25,000 shares for a total cost of $ 5,000
18,000 shares for a total cost of $ 3,600
12,000 shares for a total cost of $ 2,400
5,000 shares for a total cost of $ 1,000

6. Participation Costs
The only cost to you in relation to the Offer is the issue price of the number of Shares you wish to acquire. Under the Offer, you do not have to pay for brokerage, commission or other transactions costs.

7. Allotment of Shares
The Shares may be allotted progressively or at one time and will be allotted by 16 January 2006 or as soon as possible after that date. Macmin's share registry will send you a holding statement.

8. Maximum Issues Under the Plan
In accordance with the requirements of the Australian Stock Exchange, no more than 87,235,265 shares may be issued under the Plan.

9. Payment for Shares
All amounts in this Offer are expressed in Australian dollars. You must pay for the Shares by a cheque in Australian dollars made payable to "Macmin Silver Ltd" or BPAY. If you do not provide the exact amount, Macmin reserves the right to return your Application Form and payment. If that occurs, no Shares will be allotted to you.

10. Change of Offer
Macmin may change or terminate the Plan at any time. If Macmin does this, it will advise ASX. The omission to give notice of changes to or termination of the Plan or the non-receipt of notice will not invalidate the change or termination. Macmin reserves the right to allot fewer or no Shares than an eligible shareholder applies for under the Plan if Macmin believes the allotment of those Shares would contravene any law or ASX Listing Rules. No interest will be paid on any money returned.

11. Dispute Resolution
Macmin may settle any difficulty in relation to the Plan in any manner it thinks fit, whether generally or in relation to any participant, application or Share. Macmin's decision will be conclusive and binding.

12. Important Information on Price Risk to Consider
The issue price under the Plan of 20 cents per Share is a 17% discount from the volume-weighted market price of Macmin's fully paid ordinary shares on ASX during five trading days ended 9 December 2005.

Before deciding whether to accept the Offer, you should refer to the current market price of Macmin's shares which can be obtained from the financial pages of the daily newspaper, your stockbroker, or ASX.

The market price of Macmin's shares may rise or fall between the date of this Offer and the date when the Shares are issued to you under the Plan. This means that the price you pay per Share may be greater than or less than the price of Macmin's shares at the time the Shares are issued to you under the Offer. In determining whether you wish to participate in this Offer and the extent to which you participate, you should seek your own personal financial and/or taxation advice.

Macmin reserves the right to waive strict compliance with any provision of these Terms and Conditions. The powers of Macmin under these Terms and Conditions may be exercised by the directors of Macmin or any
Macmin Silver Pate100
Pate100:

Cart


27.12.05 17:16
#6


Macmin Silver 2300341www.asx.com.au/asxcharting/...te=28/06/2005&todate=28/12/2005" style="max-width:560px" >
Macmin Silver Pate100
Pate100:

Share Structure


27.12.05 17:22
#7
@Fundamental
Kenne den "Hanseatischen Wirtschaftsdienst" leider auch nicht.
Bin bei meinen Recherchen auf diesen Artikel gestoßen.
Die aufgeführten Daten sind aber soweit korrekt. Decken sich mit anderen Daten...


Shares listed : Australian Stock Exchange (ASX)
Trading symbol : MMN
Shares issued : 381,298,797
Options (30 October 2008/25 cents) (MMNO) : 56,811,795
Options (between 06 September 2002 &
06 September 2007 / 13.0 cents) (unlisted) : 250,000
Options (12 November 2008) / 20 cents) (unlisted):  6,300,000
Options (31 December 2007 / 20 cents) (unlisted): 3,600,000
Options (01 December 2008 / 15 cents) (unlisted): 1,900,000
Options (01 November 2009 / 20 cents) (unlisted) 2,500,000
Macmin Silver Pate100
Pate100:

Twin Hills Silver Project


27.12.05 17:26
#8

Twin Hills Silver Project

Twin Hills Site Activity (Photos) - November 2005

Macmin Silver 2300359


AUGUST 2005 UPDATE

TWIN HILLS SILVER MINE CONSTRUCTION

The progress of construction undertaken around the Twin Hills mine site is highlighted in a series of photos which form part of this update.

  • Unseasonal wet conditions in late June and throughout July have delayed the final shaping of the leach ponds and pad area until this week. Ground conditions for the laying and welding of the High Density Polyethylene (HDPE) liner have to be very dry to ensure quality welding and the integrity of the seams. The HPDE liner has been delivered to site and will be laid once a contractor ‘crew' is available.

  • The requirement for crushed and screened ‘products' to be used during the construction activity has resulted in the commissioning of the Extec crushing and screening plant units. Waste rock and alluvium source materials, located within the Twin Hills Mining Lease, have been utilised for this purpose. As an example, one of these products is being used as the underlay protection layer for the HDPE liner on the leach pads and in the process ponds.

  • Test work on the thirty (30) tonne silver ore sample extracted from a small surface slot near the top of the Twin Hills ore deposit is ongoing. Whilst a quantity of silver powder has been obtained, tests are in progress to optimise the leaching, stripping and purity of the silver powder.

  • A programme of ‘grade control' drilling is currently being undertaken over the central part of the Twin Hills ore body. The aim of this drilling is to delineate the initial 200,000 tonnes of ore to be extracted from the deposit. Once this ore is mined, crushed and agglomerated, it will be stacked in 50,000 tonne cells on the heap leach pad where it will undergo leaching. These ‘pregnant' solutions from the heaps will be pumped through the electrowinning circuit as part of the commissioning phase to optimise the production of the silver powder product.

  • Delays encountered during the construction phase, including wet weather and longer than anticipated lead times in sourcing all the components for the crushing (ex UK) and stacking circuits have meant that the construction phase has been extended. We had initially hoped to finish construction by October, but now believe that construction will be completed prior to the end of 2005.

The rise in the silver price over the last six months has not advanced as strongly as we might have anticipated, but is rising nonetheless. It has always been the intention of the Company to commence silver production once a strong up-trending silver price is in place; as the management is committed to maximising shareholder value from the development of the present reserves. The delays incurred to-date are not expected to adversely impact on the project.

Our present schedule is to complete construction towards the end of 2005, commission the plant in early 2006 with full production (subject to silver price) soon thereafter.


D.M. O'Neill
MANAGING DIRECTOR

Macmin Silver 2300359

Also available as a PDF File (372K)

Macmin Silver 2300359

Brochure - Twin Hills Update - April 2005

Macmin Silver 2300359

Twin Hills Silver Project Update - March 2004

The Macmin Board has decided to proceed with construction and commissioning of a silver processing plant and related infrastructure at the Texas Silver Project in SE Queensland Australia. Financing details will be announced in the near future.

As a result of recent increases in the silver price, and as the Board considers that silver prices will continue to rise over the next year, the Board concluded that it is now opportune to prepare for silver production. The objective would be to complete construction by the end of 2004 and plant commissioning by March 2005. This process can be shortened if warranted by silver prices.

As part of processing commissioning, it is intended to trial various heaps and dumps of ore of up to 200,000 tonnes, using among other things, innovative blasting patterns to facilitate fracturing of the ore which could lead to improved recoveries.

Silver/gold production rate will be determined in 2005, dependent on the silver price prevailing at the time; technical results from the commissioning process; and the results of the ongoing resource definition drilling. Initial production (may be increased in the future) is likely to be between two and three million ozs of silver equivalent.

Macmin Silver 2300359



Macmin Silver permanent
permanent:

Hi Pate100,


27.12.05 18:21
#9
interessanter Thread. Ich hatte MacMin vor einiger Zeit auf der Watch habe den Wert dann aber nicht weiter verfolgt, war wohl ein Fehler.
Der Kapitalbedarf war seinerzeit noch recht hoch und es Bestand so gut wie kein operatives Geschäft. Der CEO von MacMin ist ein absoluter Silberbulle -auch ich wie bekannt recht optimstisch für Silber-.

Wünsche dir noch einen schönen Abend

permanent
Macmin Silver Pate100
Pate100:

Moin Permanent

2
28.12.05 12:07
#10
Hatte die Aktie auch etwas aus den Augen verloren bin aber wieder
drauf aufmerksam geworden.
Und es hat sich einiges zum positiven entwickelt.
Im ersten Quartal 06 wird die Miene fertig gestellt und die Produktion
kann beginnen. Momentan (d.h bis gestern) sind die mit ca.51 Mio Euro bewertet.
Im Januar kommen aber noch mal maximal 87,235,265  Aktien hinzu.

Denke da ist noch etwas Potenzial!
Außerdem wird das Silber zum Marktpreis verkauft! Es ist nix
gehegt oder vorverkauft. Sollte sich Silber also positiv entwickeln so wird
Macmin voll davon profitieren. In die andere Richtung natürlich auch.


grummel heute ist der Kurs schon bei 0,16  +12%... Habt ihr etwa gestern alle noch gekauft? :-)
shit ich habe noch nicht gekauft...

Gruß Pate

       Macmin Silver 2301309

Macmin Silver slowburn06
slowburn06:

Top Empfehlung im neuesten Aktionär


08.02.06 12:12
#11
"Macmin - es geht los!"
Zielkurs liegt laut der Aktionär bei 0,30 €.
Macmin Silver Paddy666
Paddy666:

Würdet Ihr hier einsteigen?


08.02.06 14:24
#12
100% klingen ja verlockend und die Aktie hatte keine
größeren Einbrüche. Geschäftlich sieht es laut Aktionär sehr gut aus.
Die Firma will noch in diesem Halbjahr einen neue Silbermine in Betrieb
nehmen. Bitte um eure Meinung!
Macmin Silver Pate100
Pate100:

...


08.02.06 16:06
#13

Nach Aktienausgabe momentan mit ca. 65 Mio bewertet.
MacMin ist prinzipiell ein klarer Kauf!
Jedoch rechne ich mit einer Korrektur beim Silber.
Dies könnte den Kurs negativ beeinflussen. Man sollte
vielleicht den Ausbruch aus der momentanen Dreiecksformation
abwarten.

Aber wenn der Aktionär zum Kauf blässt kann ja nix mehr passieren...lol

16 January 2006

Australian Stock Exchange Limited
Company Announcements Office



Dear Sir,

SHARE PURCHASE PLAN COMPLETED
EXERCISE OF OPTIONS



The Company will today issue 25,536,000 shares pursuant to 1,208 applications received for the Share Purchase Plan which closed on 10 January 2006. The issue raised $5,107,200 before costs.

An additional 28,440 shares will be issued in respect of the exercise of MMNO listed 25cent options.

An Appendix 3B in respect of the exercise of options is attached.

Yours faithfully,

MACMIN SILVER LTD




New Issue announcement,
Application for quotation of additional securities and agreement

8. Number and class of all securities quoted on ASX (including the additionalsecurities)

Number           Class

406,863,237      Ordinary Shares Fully Paid


                          (including additional 25,536,000 issued pursuant to Share
                          Purchase Plan and 28,440 from the exercise of options)

406,863,237      TOTAL SHARES

56,783,355        Options exercisable on or before 30 October 2008
                           (after 28,440 deducted)

56,783,355        TOTAL OPTIONS


9. Number and class of all issued securities not quoted on ASX (including options,
preference shares, convertible notes, partly paid shares, loan securities, etc.)

250,000                        Non transferable Options (Employees) exercisable on or before
                                      6 September 2007 at 13 cents.

6,300,000                     Non transferable Options (Employees) exercisable on or before
                                     12 November 2008 at 20 cents.

3,600,000                     Non transferable Options (Directors) exercisable on or before
                                     31 December 2007 at 20 cents.

1,900,000                     Non transferable Options (Employees) exercisable on or before
                                     1 December 2008 at 15 cents.

2,500,000                     Non transferable Options (Employees) exercisable on or before
                                     1 November 2009 at 20 cents.



Macmin Silver Pate100
Pate100:

...


08.02.06 16:11
#14

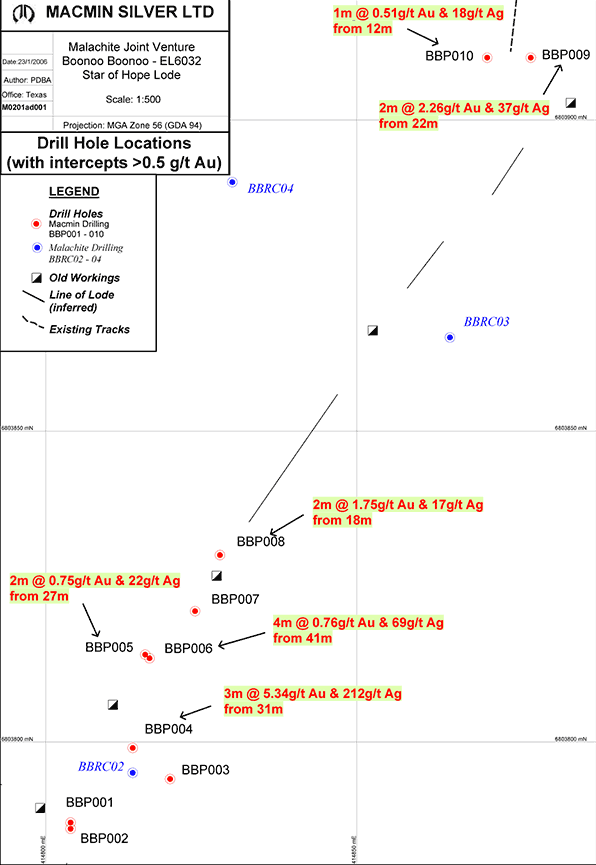

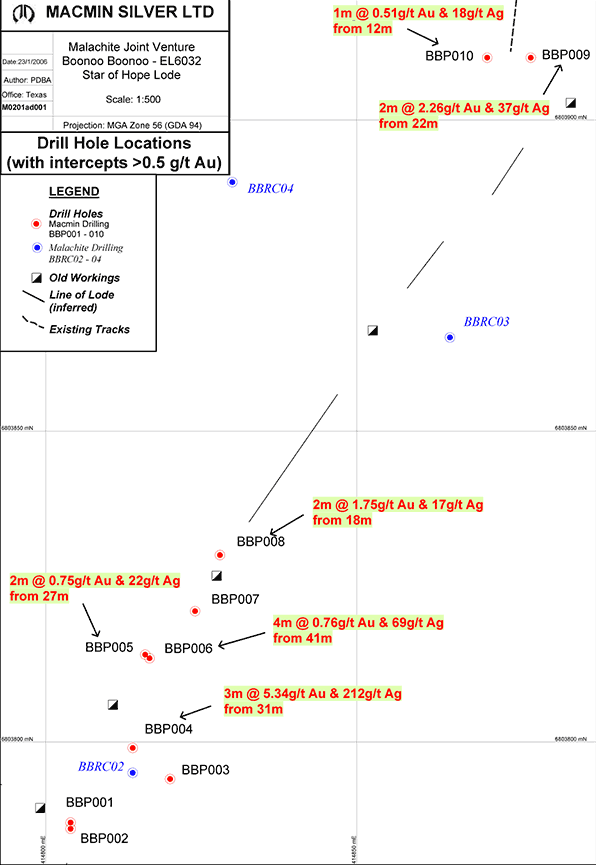

25 January, 2006MACMIN CONFIRMS SILVER-GOLD MINERALISATION AT STAR OF HOPE LODE, BOONOO BOONOO PROJECTMacmin has completed a preliminary programme of percussion drilling on the Boonoo Boonoo project, which forms part of the Joint Venture Agreement with Malachite Resources N.L.Significant results were obtained from the Star of Hope lode where ten (10) holes were drilled for a total of 403m drilled. The highest intercept occurred in hole BBP4 where 3m at 5.34g/t gold and 212g/t silver were encountered from 31m downhole (Fig 1). A table of intercepts greater than 0.5g/t Au is presented below.Hole No.Co-OrdsInterval (m)Width (m)Gold (g/t)Silver (g/t)BBP004414,8146,803,79931 - 3435.34212BBP005414,8166,803,81427 - 2920.7522BBP006414,8166,803,31341 - 4540.7669BBP008414,8286,803,83018 - 2021.7517BBP009414,8786,803,91022 - 2422.2637Samples were collected at 1m intervals and chemical analyses were undertaken at the ALS Chemex Laboratory in Brisbane.It is encouraging to see that these results confirm the presence of gold/silver mineralisation at potentially economic levels at the Star of Hope lode. It should be noted that the percussion drilling technique may not lend itself to providing accurate widths of mineralisation, when testing vein systems which host gold, due to potential downhole sample contamination. Consequently, a reverse circulation (RC) drilling rig will be used to further assess the Star of Hope lode in the coming months.Percussion drilling was attempted at three other lodes (i.e. Specimen Gully, Demonstration and Golden Crown) and was largely unsuccessful due to the presence of water at shallow depths, which prevented adequate testing of the lodes. When a Reverse Circulation rig is brought back to evaluate the Star of Hope lode, testing of these other lodes will also be undertaken.In February, drilling will commence on the Rivertree Project, the other project in Northern NSW subject to the Malachite Resources Joint Venture.D.M. O'NeillMANAGING DIRECTOR
(Verkleinert auf 93%) vergrößern
Macmin Silver 29062
Macmin Silver Pate100
Pate100:

Auszug aus dem Technischen Bericht


14.02.06 16:29
#15

AUSZUG AUS DEM TECHNISCHEN BERICHT - QUARTAL ENDEND AM 31. DEZEMBER

Macmin Silver Ltd. (Macmin) ist eine auf Silber fokussierte Gesellschaft, deren Hauptprojekt das Texas Silber Projekt in SO Queensland, Australien, darstellt. Macmin hat durch die Beteiligung von 27% an New Guinea Gold Corporation (NGG) und eine Netto Schmelzgebühr von 1% auf die Produktion von NGG auch eine Exposition zum Gold. Zusätzlich unterhält Macmin Aktieninvestitionen in den australischen Junior Exploreren Malachite Resources NL und TasGold Ltd.


TEXAS SILVER MINES PTY LTD

Das Texas Projekt (Explorationslizenzen 8854, 11455 und 12858; Abbaulizenzen ML5932 und ML50161) ist 100 km westlich von Stanthorpe gelegen. Texas Silver Mines Pty Ltd ist eine im vollständigen Besitz befindliche Tochtergesellschaft von Macmin Silver Ltd.


Twin Hills (ML 50161) - Entwicklungs Aktivitäten

  • Konstruktionsaktivitäten bei Twin Hills nahmen während dem letzten Quartal 2005 zu, mit bis zu 20 Arbeitern an Ort.
  • Detaillierte Konstruktionspläne zu den benötigten Bauarbeiten für die Konstruktion eines Sturm-Sicherheitsdammes wurden durch die Ingenieur-Beratungsfirma Ove Arup abgeschlossen. Die Bewilligung der Konstruktion durch das Umweltschutzamt wurde erhalten und erlaubte den Beginn der Arbeiten. Daraufhin wurden die Vegetation entfernt, sowie Bohrarbeiten und Sprengungen durchgeführt und es wurde ein Fundament in den darunterliegenden Fels eingelassen, auf welchem die Mauern konstruiert werden wird. Aufgrund der Einschränkungen, die das nasse Wetter mit sich brachten, wird die Konstruktion der Mauern im Februar beginnen.
  • Hauptkomponenten der Elektrizitäts-Gewinnungsanlage wurden durch Electrometals im Dezember an Ort geliefert und der Aufbau der Anlage wird während dem ersten Quartal 2006 in Angriff genommen. Die ersten Lieferungen von in Italien produzierten mit DSA beschichteten Anoden sind im Januar eingetroffen. Der Zementboden und die Stahl-Armierungen für den Bau der Anlage wurden fertiggestellt.
  • Die ausbleibende Lieferung eines Zerkleinerers von einem Hersteller aus Grossbritannien für die Zerkleinerungsanlage, führte nach einer Wartezeit von fünf Monaten zur Annulierung der Bestellung während dem Dezember-Quartal. Ein Ersatz wurde in Westaustralien aufgetrieben und ist nun an Ort angekommen. Die Zerkleinerungsanlage wird auf Ende des ersten Quartals 2006 zusammengebaut und für die Inbetriebnahme bereit sein.
  • Ein umfangreiches Programm an Gradkontrollbohrungen wurde während des Quartals durchgeführt. Weitere Bohrungen laufen aktuell, so dass ein großer Teil der oberen 20m des Erzkörpers vor dem Beginn der Errichtung des Dammes im Februar bebohrt sein wird.
  • Ein weiteres Update zur Konstruktion und ein überarbeiteter Terminplan für die Produktion werden im Februar zur Verfügung gestellt.


Explorations-Bohrungen

Toolbox Schürfgebiet

Das Toolbox Schürfgebiet liegt etwa 3,5 km nördlich von Twin Hills. Ein Programm mit 17 Schlagbohrungen testete eine niedrig gradige Basismetallanomalie, die vorher bei geochemischen Untersuchungen definiert werden konnte. Obwohl Bohrproben erhöhte Konzentrationen an Basismetallen und Silber ergaben, waren die Werte lediglich im Bereich von Anomalien. Eine Zink-Blei Anomalie ist noch für Bohrungen offen.

Boonoo Boonoo Projekt

Macmin hat ein Vorprogramm mit Schlagbohrungen im Boonoo Boonoo Projekt in Nord NSW, als Teil der Joint Venture Vereinbarung mit Malachite Resources N.L. beendet. Signifikante Resultate wurden in der Star of Hope Ader zu Tage gefördert, wo über eine Länge von 403 m zehn Schlagbohrungen niedergebracht wurden. Das beste Ergebnis stammt aus Loch BBP4, wo über 3 m 5,34 g/t Gold und 212 g/t Silber in einer Tiefe von 31 m gefunden wurden.
Weitere Bohrungen mit einem RC Bohrer werden folgen, um die Adern vollständig bewerten zu können.



ZUM UNTERNEHMEN

Aktienkauf-Plan

Ein Aktienkauf-Plan für die Aktionäre wurde am 10. Januar 2006 abgeschlossen, mit welchem vor Kosten $5'107'200 eingenommen wurde. 25'536'000 neue Aktien wurden ausgegeben, entsprechend 1'208 Anträgen von Aktionären.

Die Gesellschaft hat zur Kenntnis genommen, dass eine relativ grosse Zahl von berechtigten Aktionären, deren Aktien durch Stellvertreter gehalten werden, über das jüngste Angebot für den Kaufplan nicht informiert wurden. Dies scheinbar aufgrund einer Regelung von gewissen Stellvertreter-Firmen, in Bezug auf die Weiterleitung von Aktienkauf-Plan-Angeboten an deren dahinterstehende Kunden.

Das war ausserhalb der Kontrolle von Macmin Silver Ltd; wir möchten dennoch den Aktionären, die die Gelegenheit nicht hatten, am Angebot teilzunehmen, weil ihre Aktien durch Stellvertreter gehalten werden, unser Bedauern ausdrücken.

Übersetzung durch silberinfo.de


Macmin Silver Pate100
Pate100:

update

2
02.09.06 16:02
#16
wird die Produktion wieder nach hinten verschoben?
siehe drittletzter abschnitt.

"Now that draft conditions for the EA are being finalised by the EPA, ongoing requests for additional engineering related input into site activities, never foreseen in the original EMOS document, could continue to affect the mine production schedule."

Never ending story...

31 August, 2006

TWIN HILLS SILVER MINE - UPDATE

SENIOR MINE EXECUTIVE APPOINTMENTS

Macmin is pleased to announce the appointment of Mr Bill Guthrie to the position of General Manager - Operations, responsible for the management of the Twin Hills Silver Mine. Bill held a number of senior management positions including Process Manager and Research Manager within Queensland Magnesia, based at Rockhampton, over a 15 year period from 1990 to 2005. The appointment is effective from 21 August 2006.

Mr Norman Davidson has accepted the position of Senior Mining Engineer with responsibility for the oversight of mining services at both Twin Hills and associate company, New Guinea Gold's Mt Sinivit gold project (PNG), currently under construction. Norman has over 35 years' experience, having worked in Indonesia, Papua New Guinea, Australia and more recently (since 1990) as a Consulting Mining Engineer in New Zealand and Canada.

These appointments broaden the management skills base of the Company as it moves towards a more production based focus.

CONSTRUCTION / COMMISSIONING ACTIVITIES

A total of 403 drill holes to an average depth of 26m were completed on the grade control drilling to the end of July. These holes were in addition to the close-spaced drilling carried out prior to the grade control programme, and have now completed coverage on a 6 x 6m block basis to the 490 level within an area of 250 x 150m over the initial pit area. The programme was successful in providing geological data for mine planning purposes and has supported the block model of the Twin Hills orebody.
The final equipment supplied by Mearns Environmental Contracting required for the mining fleet arrived on-site in mid-August and now includes:
3 Caterpillar 773B rear dump trucks
1 Komatsu PC1000 excavator
1 D9 dozer
1 grader
1 roller

In addition, Macmin owns the following equipment on-site:

1 water truck
1 PC300 excavator
1 WA470 loader
plus ancillary maintenance vehicles
The Company is now preparing to commence mining at Twin Hills i.e. drill and blasting waste and ore; digging and trucking waste to the waste dump and trucking ore to the crushing circuit in readiness for heap building.
Low grade ore is currently being crushed, using the mobile crushing equipment, and laid as the drainage layer prior to heap construction.
Commissioning of the fixed crushing circuit, including agglomerator and overland conveyors, is scheduled for the first week in September.
Work is continuing on the storm containment dam.

As part of the process for Macmin to be granted the Twin Hills Mining Lease in 2001, an Environmental Management Overview Strategy (EMOS) document was compiled detailing all development and mining related environmental aspects of the project. The statutory reporting body in 2000 was the Department of Natural Resources and Mines which granted the Mining Lease and approved the EMOS.

In 2001 the EPA took over responsibility for all mining environmental issues under a new Environmental Protection Act and issued the Company with a "Transitional Authority", which allowed us to continue activities on the Mining Lease under the previous EMOS conditions while conditions for an Environmental Authority (EA) were determined. Now that draft conditions for the EA are being finalised by the EPA, ongoing requests for additional engineering related input into site activities, never foreseen in the original EMOS document, could continue to affect the mine production schedule. This is in part due to time constraints in consulting and engineering availability in the current resources economic upturn. However, the schedule as per the last quarterly report is still targeted by the Company.

It should be noted that at a recent on-site meeting with officers of the EPA it was agreed that there were no fundamental environmental impediments to the advancement of the Twin Hills mining operation.

The Company will now prepare regular monthly updates to shareholders and investors on all aspects affecting the mine start-up timeframe.
Macmin Silver BoMa
BoMa:

aktuell


04.09.06 09:31
#17
in Frankfurt 10,80 % gestiegen ??? Danke für Dein update oben, Pate !!!  .-)))
Macmin Silver BoMa
BoMa:

also dieser Bill Guthrie


04.09.06 12:03
#18
scheint eine weitere Explorer-Größe zu sein... hab von dem schon mal gelesen, weiß aber leider nicht mehr, in welchem Zusammenhang.

Frage: "in addition, Macmin owns the following equipment..."

1 water truck.. etc.

Water truck, Frage an alle Bergbau-Spezialisten: evtl. zum Spülen von Gestein ???

Macmin Silver BoMa
BoMa:

Leutz


04.09.06 12:05
#19
da stehen in Frankfurt 1.000.000 Stück im Brief für 0,235....
Macmin Silver Hirschmann
Hirschmann:

BoMa


04.09.06 12:13
#20
Macmin Silver 2769230i11.ebayimg.com/03/i/08/21/84/8f_12.JPG" style="max-width:560px" align=left border=0>
Macmin Silver Hirschmann
Hirschmann:

BoMa


04.09.06 12:17
#21
Diese "Water Trucks" werden in der Regel als Wasserspender für die Arbeiter benutzt,lassen sich aber auch ebenfalls mit Hochdruckgeräte kombinieren die Gestein,Lehm usw. auswäscht.

Hirschi :-)
Macmin Silver Hirschmann
Hirschmann:

BoMa


04.09.06 12:20
#22
Macmin Silver 2769252static.flickr.com/33/52108272_6c781bc099.jpg?v=0" style="max-width:560px" align=left border=0>
Macmin Silver BoMa
BoMa:

ach Du meinst


04.09.06 12:29
#23
...die arbeiten da nackt ??? und so viele Damen dabei... ggg
Macmin Silver Hirschmann

BoMa


#24
Könnt mich da ja mal als "Fachkraft" bewerben oder ? ;.)


Hot-Stocks-Forum - Gesamtforum - Antwort einfügen - zum ersten Beitrag springen

Neueste Beiträge aus dem Alcyone Resources Forum

Wertung Antworten Thema Verfasser letzter Verfasser letzter Beitrag
47 2.446 Alcyone R.- The next australian silverproducer ? Calibra21 schakal1409 25.04.21 01:13
12 178 Alcyone Resources reiner Fakten Thread Andreito Andreito 31.05.13 14:47
11 368 Macmin Silver wird Explodieren PANGÄA louisaner 03.11.09 15:56
4 660 Silber geht bald zu Neige! gold Silberlöwe 21.12.07 15:43
  23 Macmin Silver Pate100 Hirschmann 04.09.06 13:03

--button_text--
